DARIN · RE-LOCATE + IDENTIFY

A location change should be a calculation, not a risk.

What the same part costs in four countries, built from its own process chain and each location's labour, energy and overhead structure — and what the supplying plant's real rates say about the price you pay today.

TWO LEVERS, ONE COST MODEL

Same part, same calculation, different location.

4 Countries Compared in one relocation scenario
Per Plant Real rates instead of country averages
Factory Cost Calculated from the part's process chain
€1B+ Analyzed spend across 250+ categories
Factory cost is not landed cost

41 € against 28 € is a factory-cost comparison. A sourcing decision needs more.

The country calculation is the honest starting point: it tells you whether there is anything worth investigating. What turns it into a decision is the list below — and we will tell you in the scoping call which of these we quantify for your case rather than pretend they are all in the model.

The decision frame Which of these we quantify is scoped per engagement
  1. 01

    Freight and packaging

    Distance, mode, part density and packaging requirements can consume a large share of a labour-cost advantage — especially on heavy or bulky parts, where a container of air is expensive.

  2. 02

    Duties, tariffs and origin rules

    Duty rates and rules of origin change what the same part costs at your gate, and they change faster than a cost model does. This is a live input, not a constant.

  3. 03

    Inventory and working capital

    Longer transit means more stock in the pipeline and larger safety stock. That is real capital cost, and it belongs on the same page as the piece price.

  4. 04

    Minimum order quantities and lot sizes

    A lower piece price at a minimum order of 5,000 is not a lower cost if you need 800 a year. Quantity and location interact — which is why the two levers are calculated together.

  5. 05

    Lead time and flexibility

    Six weeks of transit removes options you currently have for free: reacting to a demand change, correcting a defect batch, pulling a delivery forward.

  6. 06

    Quality cost and qualification

    Sampling, first-article inspection, audits, travel, and the cost of the learning curve at a new plant. These are one-time costs that a piece-price comparison ignores.

  7. 07

    Tool transfer and ownership

    If the tool is at the current supplier, moving it — or building a new one — is a large part of the business case. Who owns it decides whether relocation is even practical.

  8. 08

    Currency, energy and risk exposure

    Exchange-rate movement, regional energy prices, capacity, export controls and geopolitical risk all sit in the decision. Some can be modelled, some can only be named — and naming them beats leaving them out.

R · Re-locate

The same process chain, priced in each country.

Re-locate does not apply a country factor to a finished price. The part's own process chain is recalculated with the labour, energy and overhead structure of the location in question — so the comparison is between two calculations, not between a price and an assumption.

32 €/h
Example labour rate, Germany
8 €/h
Example labour rate, China
01
Labour rate and operator factor
Example rates from the calculator: Germany 32 €/h · Poland 12 €/h · China 8 €/h · United States 28 €/h. What matters is not the rate alone but the labour time the part actually needs — a highly automated step barely moves when the wage does.
Identical pallets of parts staged for shipment next to a container
02
Energy and overhead structure
Indirect cost, energy and facility overhead differ by location and, since 2022, differ far more than they used to. The factor applied is the one of the plant that actually makes the part.
03
Machine landscape
A lower wage does not help if the local process is less productive. Machine rate and throughput per step are part of the country calculation, not an afterthought.
04
Where relocation does nothing
On a material-dominated part, moving production barely moves the price — material is bought at broadly comparable market prices. The calculation shows that before anyone spends a quarter on a sourcing project.
05
Scenarios instead of a single answer
Four or five locations calculated side by side, with the same part and the same quantities, is more useful than one recommendation — because the decision usually depends on factors outside the cost model.
Example calculation

One part, two locations.

FTE-0001 is a laser-cut and bent sheet-metal bracket — the same example part used throughout the DARIN pages. Below is what changes between two production countries, and what does not.

Factory cost example 41 € → 28 € Same part, same process chain, different location
Labour rate 32 → 12 €/h Example rates from the calculator
Material Unchanged Bought at comparable market prices
FTE-0001 · sheet-metal bracket · factory cost Example
InputGermanyPolandWhat it does
Re-locate Labour rate per hour 32 €/h 12 €/h Applies to the labour time the part actually needs. On a part with little manual content the effect is small; on a labour-intensive one it dominates.
Re-locate Energy and overhead factor German factor Polish factor Carried by the process cost, not the material — so it scales with machine and labour time, not with part weight.
Re-locate Material cost 2.12 €/kg · 13.6 kg Broadly the same Steel is a traded commodity. Where material dominates the part cost, relocation is the wrong lever and the calculation says so.
Identify Whose rates are used Country-average rates The named plant's actual rates Turns a theoretical country comparison into a statement about a specific supplier: is this price what that plant's cost structure implies, or more?

Example values from the FTE-0001 sheet-metal part in the DARIN calculator. An example, not a commitment. Average savings potential identified in COVALYZE Fast Track and platform engagements since 2019. Identified potential is not the same as realised savings — actual results vary by commodity, supplier base, quantity structure and data quality.

In the platform

What the same part costs in each region — down to energy and CO₂.

The cost stack is recalculated per production country: material, machine, labour and setup, the overhead contained in the total, the energy the part consumes in kWh, and the CO₂ that follows from the local grid intensity. Beside it, the supplier view breaks the covered spend into machine capital, energy and labour — the three drivers that actually explain why another region is cheaper.

Cost and CO₂ by region Product view

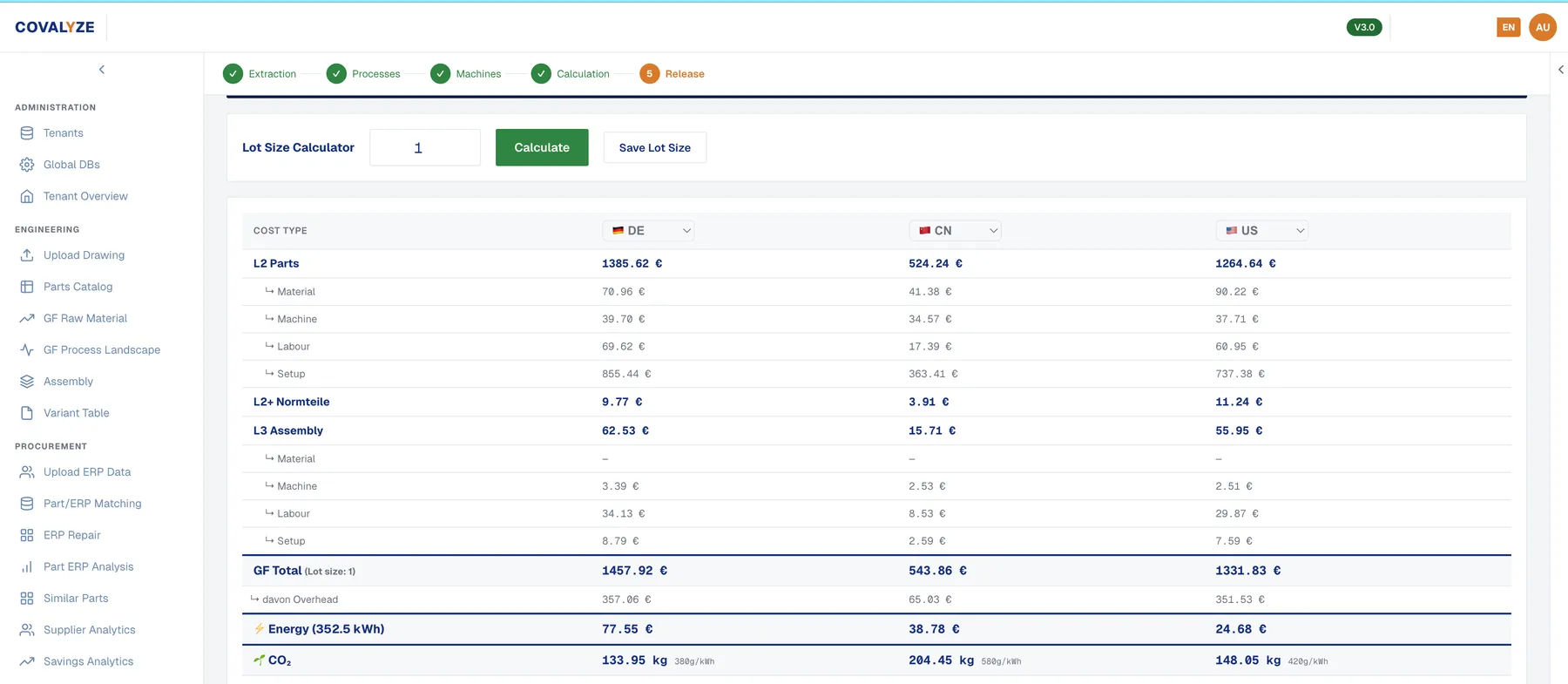

DARIN cost table comparing Germany, China and the United States including overhead, energy in kWh and CO2 in kilograms
Germany, China and the United States side by side on one calculation. Energy is priced per country and the CO₂ figure uses that country's grid intensity in g/kWh — so the cheapest region is not automatically the cleanest.
Regional drivers per supplier Product view
DARIN supplier value-chain view with a regional driver table for machine capital, energy and labour
Per supplier: where the value sits today, and what machine capital, energy and labour would cost in each region — each shown separately instead of as one country factor.

Screenshots from a demonstration tenant; supplier names are pseudonymised. These are factory-cost figures plus energy and CO₂ — freight, duties, inventory and qualification are the decision frame described above, scoped per engagement.

I · Identify

Identify means the plant's real cost structure — not a supplier search.

The lever exists because a country average says little about the supplier in front of you. Two plants in the same country, with different machines and utilisation, produce genuinely different costs. Here is what that does and does not include.

COVALYZE specialist presenting a supplier cost analysis
20-minute scoping call
Tell us the sourcing question. We'll say what is calculable.
Talk to a specialist
Identify does
Calculate factory cost per country from the part's own process chain
Split the regional difference into machine capital, energy and labour
Price the part's energy consumption per country and derive its CO₂ from the local grid intensity
Replace country averages with the actual rates of a named plant
Show which suppliers price above what their cost structure implies
Rank parts by how much a location or supplier change would be worth
Identify does not
Search for and name alternative suppliers as part of the calculation
Prequalify or audit a supplier
Run an RFQ or a sourcing event
Plan or manage a production transfer
Guarantee that a calculated country advantage survives as a landed cost
What we need from you

A location comparison needs more than a drawing.

For a sourcing question the commercial context matters as much as the geometry. Missing items do not block the analysis — they become stated assumptions instead, and we flag which ones would change the answer.

Per part, for a sourcing scenario 10 deliverables
01 Current supplier and the plant that actually produces the part
02 Production country of that plant
03 Current price and currency
04 Annual quantity and order quantity
05 Incoterms and, where known, the logistics route
06 Tool ownership: yours, the supplier's, or shared
07 Lead time and any agreed delivery commitments
08 Defect or complaint rate, where you track it
09 Existing contractual conditions and their remaining term
10 The drawing or specification — as for every DARIN calculation
Paid price and quantity against should-cost per region, part by part

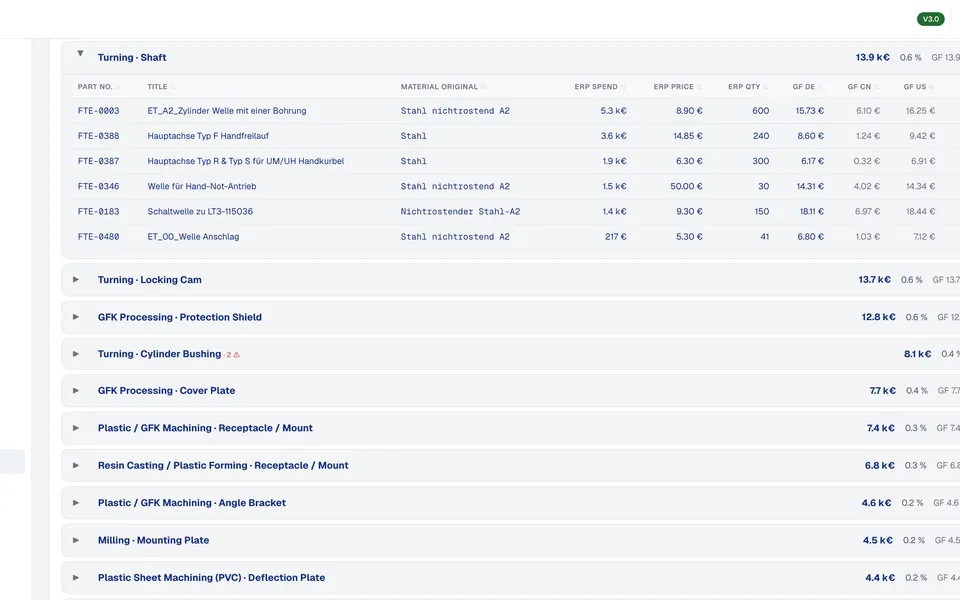

DARIN cluster view listing paid ERP price, quantity and should-cost for Germany, China and the United States per part

Client result · private equity portfolio company

Germany, Romania, Poland, China — on one costing logic.

A 44-component welded assembly weighing 40 kg was costed live during an investor meeting, producing a structured should-cost above EUR 1,600 within seconds and 200–250+ parameters straight from the 3D model. The same cost logic was then used to compare regional production scenarios across four countries — the point being that a location question is answered with the part's own calculation rather than with a separate spreadsheet exercise.

In the turned-parts category the neighbouring lever mattered more: 50 high-runner parts were spread across more than 10 suppliers, and fragmentation — not location — was the finding. Which lever wins is an output of the analysis.

Average savings potential identified in COVALYZE Fast Track and platform engagements since 2019. Identified potential is not the same as realised savings — actual results vary by commodity, supplier base, quantity structure and data quality.

The five levers

Re-locate and Identify are two of five.

A location scenario is rarely the whole answer — quantity structure and design decisions usually move the same part too.

Global sourcing cost analysis — frequently asked questions.

Scope of the calculation

The calculation starts from factory cost: the part's process chain priced with the machine, labour, energy and overhead structure of a given location, including the energy it consumes in kWh and the CO₂ that follows from that country's grid intensity. Freight, duties, inventory, qualification and tool transfer are part of the decision, and we scope in the kickoff which of them we quantify for your case and which we name as open items. A country comparison presented as a finished landed cost would be a guess dressed up as a number.

Implementation

Not as part of the calculation. DARIN quantifies what a different location or a different cost structure would be worth, and prioritizes the parts where that is largest. Supplier search, qualification, RFQ execution and transfer planning are separate engagements — we would rather scope them explicitly than imply they are included.

CTA background

Turn the location question into a calculation.

Send one part with its supplier, plant, prices and quantities. You get the factory cost per location, the plant-rate comparison, and a clear statement of which landed-cost elements we quantified and which remain open.

Compare a sourcing scenario
